FTTH Installation Methods and Cost Reduction Strategies
FTTH installation costs depend on the route you can actually build: available duct space, permissions, crossings, reinstatement and the final connection into each property. A fast blowing machine cannot compensate for a blocked duct or an inaccessible building entry.
This guide compares FTTH installation technologies, explains where microducts and fiber blowing fit, and shows how to compare construction options without confusing a low cable price with a low installed cost.
Compare FTTH installation methods by route
Choose the civil construction method before specifying the cable installation equipment. One rollout may reuse ducts along a street, use directional drilling at a crossing and use an aerial drop for a particular property. Applying one method everywhere often adds unnecessary work.
| Route option | Where it can help | What to resolve before pricing |
|---|---|---|
| Existing telecom ducts | A continuous, accessible pathway with usable capacity | Access terms, proving, blockages, chamber condition and space for the proposed cable or subduct |
| Conventional trenching | New routes where depth, protection or several services require a designed trench | Utility locations, excavation quantities, separation, surface reinstatement and traffic management |
| Microtrenching | Suitable paved routes where the authority accepts the proposed slot and restoration system | Pavement structure, depth, existing services, reinstatement material and future road maintenance |
| Horizontal directional drilling | Selected road crossings or obstacles where open excavation is unattractive | Ground conditions, service locations, bore design, entry/exit space and duct pullback requirements |
| Aerial deployment | Routes with usable poles and an approved aerial cable design | Attachment rights, pole assessment, loading, clearances, spans and maintenance access |
Microtrenching can reduce excavation and reinstatement quantities, but unsuitable pavement or rejected restoration can erase that advantage. The UK government's 2011 microtrenching guidance explains these engineering trade-offs; its dimensions and prices are historical, not a current construction specification.
For network architecture, PON components and rollout planning, use the main Fiber to the Home deployment guide. This article focuses on physical installation and construction cost.
Infrastructure sharing: verify usable capacity
Existing ducts and poles can avoid duplicating civil works. Access to a mapped asset, however, does not establish that it is ready for installation. Survey the proposed path, confirm the access arrangement and price the repairs needed to make it usable.
Duct sharing in France and other markets
France provides a documented example of infrastructure access. Arcep's July 2026 report describes access processes for Orange's underground ducts and overhead infrastructure. The commercial terms and engineering rules are market-specific; they should be checked with the infrastructure owner.
Record which sections have been proved, which need clearance or repair, and who pays for that work. Allow for chamber congestion and space at bends and entries, not just nominal duct diameter. A smaller cable may help occupancy, but it still needs a compatible installation method and sufficient protection.
Sewer, water and gas routes are specialist projects
Telecom duct reuse and installation inside an operating utility pipe are different proposals. Sewer, drinking-water and gas routes require a utility-approved system, appropriate materials, controlled access and an agreed maintenance process. Do not treat them as ordinary empty ducts or apply a generic blowing pressure to them.
For an early-stage estimate, exclude these routes unless the utility owner and specialist system provider have confirmed feasibility. The same applies to de-coring a retired cable: it needs a verified, isolated asset and a suitable replacement pathway. It is not a default method for converting copper infrastructure to FTTH.
Microduct selection for FTTH installation

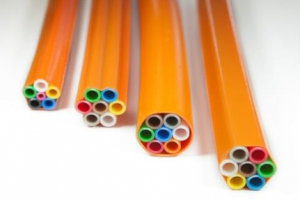

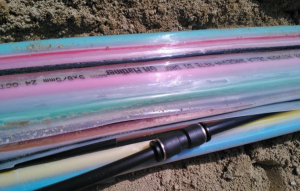

Microducts provide dedicated paths for small cables or purpose-designed fiber units. Spare paths can support later additions, provided the route, closures and building entries preserve continuity. Installing more tubes than the site needs also consumes duct space and increases initial material cost.
- Specify OD and ID: the duct's outside diameter alone does not define cable clearance.
- Check the full system: cable OD tolerance, ovality, couplers, seals and entry fittings must suit the selected machine and duct.
- Match the environment: direct burial, installation inside an existing duct and indoor routing require the relevant construction and ratings.
- Preserve the pathway: identify tubes, cap unused ends and document which routes are available for later installation.
An area-fill calculation describes occupancy; it does not predict blowing distance. The cable's stiffness, friction, bends and route condition still need evaluation. For the final customer cable, the FTTH drop cable selection guide addresses construction choices. Building fire requirements are covered in the CPR cable guide.
Fiber blowing, pulling and pushable systems
FTTH installation with cable blowing

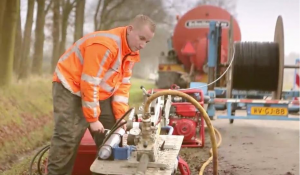

Cable blowing combines controlled mechanical feeding with airflow along a suitable duct. It can be a good choice for micro cables in a continuous, prepared path. Pressure, air delivery, seals, lubrication and cable/duct pairing work together; increasing pressure alone does not solve a blocked route.
Distinguish blown micro cable from air-blown fiber units. Purpose-designed fiber units, tubing and termination hardware form a compatible system; they are not interchangeable with any small cable. The FOA air-blown fiber reference explains that distinction.
Use the fiber optic cable blowing guide for the installation sequence and the fiber blowing engineering checklist for preparation. A Y connector supports approved overblowing into an occupied duct; it is not a general device for splitting airflow into separate branches.
Pulling: control tension through the actual route
Pulling is a practical option for suitable cables and pathways. Plan bend geometry, entry guides and intermediate access before choosing the pull length. The manufacturer's tensile limit and loaded bend radius govern the job; a short route can still be difficult if it has sharp transitions.
Corning AEN 136 discusses pulling tension, sidewall pressure and conduit fill. Use the cable's approved pulling attachment and monitor the relevant limits. Ordinary pulling gel should not be assumed compatible with cable blowing; check the blowing lubricant specification for the proposed application.
Pushable fiber and connectorized drops
A purpose-designed pushable system may suit a short, compatible route. Connector size, cable stiffness and bend geometry determine feasibility. A factory connector must pass through every restriction, including couplings and building-entry fittings. Verify the assembly's approved installation process before choosing it to avoid field splicing.
Choose the termination method with the drop design
Termination cost includes preparation, protection, testing and rework. Comparing only connector price misses the labour spent achieving an accepted connection.
| Option | Useful application | Commercial and field trade-off |
|---|---|---|

| Fusion splice and pigtail | Flexible cut lengths and protected field joints | Splicer, trained crew, splice protection and storage are required; little dependence on pre-set drop lengths. |
| Factory-terminated assembly | Repeatable routes with known lengths and compatible connectors | Reduces field termination work, but needs length stock, slack storage and protection during installation. |
| Field-installable connector | Approved site termination where the selected connector system fits the workflow | Tooling, cleave quality, training and first-pass test results determine real labour cost. |
Specify connector type, polish, optical limits and protection at the purchasing stage. Match test leads to the interfaces; APC and UPC connections require the correct mating arrangement. Do not assign one universal loss or jointing time to every connector or splice technology.
Size the enclosure for splice trays, adapter positions, cable entries and bend management. An indoor wall-mount fiber termination box serves a different purpose from an outdoor rack cabinet. Confirm the exact enclosure's intended environment.
FTTH installation cost reduction: compare complete work packages
Start with a measured route and separate the cost drivers: survey and access, civil construction, duct repairs, cables and ducts, placement labour, termination, testing and repeat visits. A longer route using proven infrastructure can cost less than a short route with several road crossings.
Worked example: duct reuse versus new trench
The following arithmetic uses invented planning rates to show the comparison. It is not a UPCOM quotation, a market price list or a reported project saving. Both options cover a 1,000 m route; cable, termination and other common costs are excluded.
| Civil works item | New trench throughout | Reuse 800 m; trench 200 m |
|---|---|---|
| New trench at assumed €45/m | 1,000 × €45 = €45,000 | 200 × €45 = €9,000 |
| Duct reuse at assumed €8/m | €0 | 800 × €8 = €6,400 |
| Additional survey/proving and repair allowance | €0 in this comparison | €6,000 |
| Compared subtotal | €45,000 | €21,400 |
The subtotal difference is €23,600. On these assumptions, another €23,600 of reuse-specific cost would remove the advantage. Replace the assumed rates and quantities with surveyed conditions, access charges, contractor offers and the actual reinstatement scope.
Track homes passed and homes connected separately
A route serving 100 premises does not mean 100 accepted customer installations. Separate shared network construction from each activated drop. If take-up is 40%, connection labour and revenue assumptions apply initially to 40 customers, while the shared route still serves 100 premises. State which denominator is used whenever comparing cost per home.
Parham: a historical case, not a current price benchmark
Nesta's March 2015 UK FTTH cost report lists Parham as a rural example from a 2014 FTTH Council study, with local agricultural contractors and a reported figure of about £2,000 per home. That published comparison does not establish a current installed price or a transferable savings percentage.
For a rural build today, compare field-boundary routes and road routes using the same scope. Include land access, maintenance rights, crossings and service connections before choosing the cheaper-looking line on the map.
FTTH installation checklist: from survey to acceptance
- Walk and document the route. Confirm access points, customer entries, utility locations, crossings and permissions. Mark unresolved sections before committing to quantities.
- Prove the proposed pathway. Check continuity, clearance and condition using the infrastructure owner's procedure. Establish which repairs are included in the price.
- Approve the cable and duct pairing. Record cable OD, duct OD/ID, fittings, environmental ratings, tensile limits and bend radii.

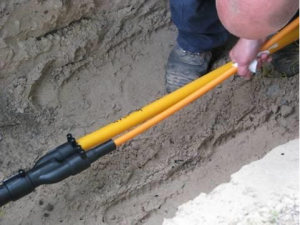

- Trial the installation setup. Confirm equipment, inserts, seals, air supply and lubricant. Record achievable performance on a representative section before forecasting the entire build.

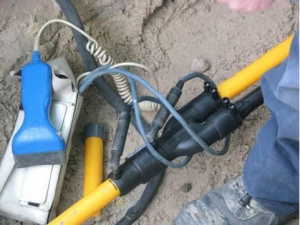

- Place and terminate the cable. Protect the cable at entries, manage slack and identify tubes, fibers and ports. Use the agreed termination system.
- Test and hand over. Inspect and clean interfaces, measure the specified optical performance, resolve failed results and deliver the as-built route and connection records.
The acceptance plan should define loss limits, test wavelengths, reference method and any required OTDR records. Splitters affect both the optical budget and trace interpretation. The FOA FTTH testing guide explains why an OTDR trace and an end-to-end loss measurement answer different questions.
Match UPCOM equipment to the FTTH route

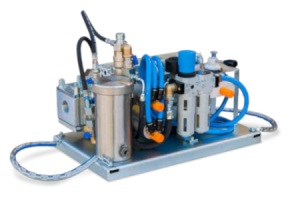

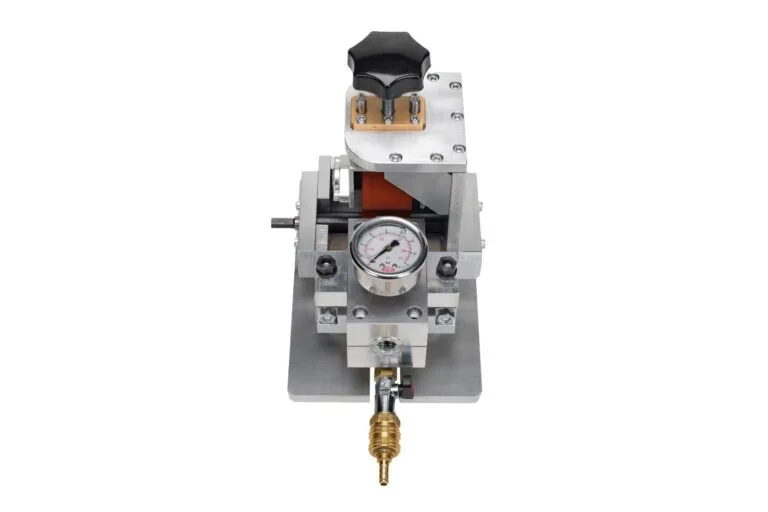

For compact micro-cable work, DrillFOK uses an external drill drive with compressed-air support. The current DrillFOK datasheet lists a 1–8 mm cable range and identifies cable/duct inserts, drill torque, compressor capacity and duct condition as selection factors. Confirm the supplied configuration against the actual project.

For other cable sizes and operating requirements, compare the cable blowing machine range. Match cable construction to the route through the fiber optic cable category; a cable's fiber grade alone does not establish its suitability for blowing, direct burial or indoor use.
Provide the route data with your enquiry
Include cable OD and construction, duct OD/ID, section lengths, bends, existing occupancy, available air supply and the required fittings. This gives the supplier a usable basis for equipment selection.
Compare installation equipmentFTTH installation questions
Which FTTH installation method is cheapest?
There is no universal cheapest method. Compare duct reuse, new construction and aerial routes using surveyed conditions, permissions, repairs, reinstatement and completed customer connections. Cable placement speed is only one part of installed cost.
Is microtrenching the same as fiber blowing?
No. Microtrenching creates a narrow construction route for cable or ducts. Fiber blowing places a compatible cable or fiber unit inside a prepared duct system. A project may use both methods on the same route.
Can any fiber cable be blown into a microduct?
No. Cable size, construction, stiffness and friction must suit the duct and equipment. Air-blown fiber units also require their own compatible tubing and hardware. Confirm the supplier's cable/duct pairing and installation limits.
Do pre-terminated drops remove all site work?
No. They reduce field termination work, but the route still needs installation, connector protection, suitable length and slack storage. The completed connection must also meet the operator's optical test requirements.
Can sewer, water or gas pipes be treated as spare telecom ducts?
No. These are operating utility systems. Installation requires a specialist, utility-approved design and maintenance arrangement. They should not be included as ordinary duct reuse in an FTTH estimate without confirmed feasibility.
